Injection drying panels and air movers running inside containment

Structural Drying

Nine Loud Machines In Your House. Here Is What Each One Does.

Drying is the part of a water loss you have to live with, so it is worth understanding. What the equipment is, how long it stays, whether you can sleep here, and who decides it is finished.

Free inspection on restoration work · Licensed C-10 & General B · Answered 24/7

What all of that equipment is.

Every piece is placed for a reason, and moving one changes the result. If something is genuinely in your way, tell the crew and it gets resolved properly.

Air movers

The low flat ones aimed along the wall at a shallow angle. They are not there to cool the room. Moving air strips the saturated boundary layer off a wet surface so evaporation can keep going, which is why the angle matters and why moving one to point at yourself sets that wall back.

LGR dehumidifier

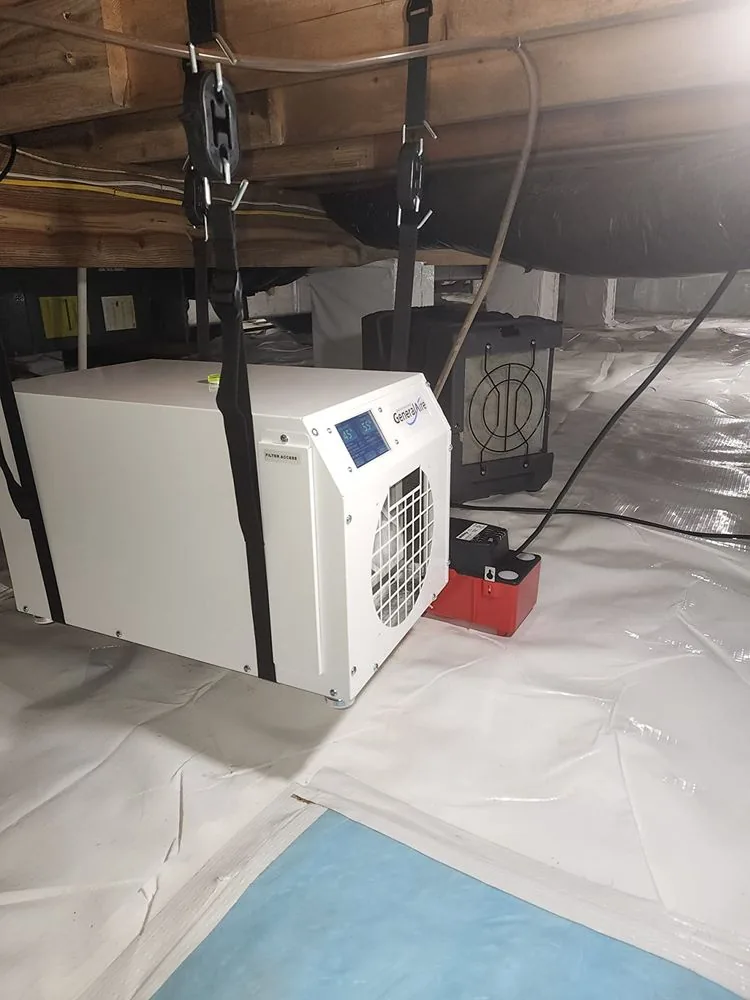

The heavy one with a hose running to a drain or a bucket. Low grain refrigerant means it can pull moisture out of air that is already fairly dry, which is the part of the job cheap rental units cannot finish. This machine is what actually removes water from your house.

Heat, on purpose

Warmer air holds more moisture, so the equipment deliberately raises room temperature to move water out of materials and into air the dehumidifier can then strip. If the house feels warm and dry, that is the process working rather than something set wrong.

Injection and mat systems

Used under hardwood, inside wall cavities, and beneath cabinet kicks. Panels or mats seal to the surface and pull air through the assembly itself, so a floor or a wall can dry in place instead of being demolished to reach the wet side.

Containment sheeting

Plastic and zippered doorways. It keeps the drying volume small enough to actually dry, and on anything with a contamination or mold question it keeps that area under negative pressure so nothing migrates into the rest of the house.

The meter and the camera

A pin or pinless moisture meter for the numbers, a thermal camera for finding water that has travelled. The camera does not see moisture, it sees the temperature difference evaporation creates, which is why it points us where to measure rather than replacing the measurement.

Why a room full of fans makes things worse.

Air movers do not dry anything. They move water out of the material and into the air, and that is the whole of their contribution. If nothing then takes the moisture out of the air, that air finds the next cold surface and gives it back, which is usually the ceiling, the far wall, or the inside of a closet nobody opened.

This is exactly how a homeowner with rented fans turns a wet bathroom into a mold problem in a bedroom. The moisture was never removed from the building. It was redistributed to somewhere with no fan pointed at it.

The dehumidifier is the half that finishes the job, and it has to be sized to the affected volume. That sizing calculation is the actual craft in structural drying, and it is why the machine count is not arbitrary.

Air movers and dehumidifier running in a contained room

Movement and dehumidification together. Either one alone is not drying.

What the days look like.

Three to five days on a typical residential loss. Saturated hardwood, plaster, or a loss across two floors runs longer, and we would rather tell you that on day two than on day five.

  1. Day 1

    Baseline and setup

    Affected and unaffected readings taken and recorded, extraction finished, equipment placed and counted. You get the first photo set and moisture map the same day.

  2. Day 2

    First honest check

    Same points re-read. Numbers should have moved. If a point has not, the equipment gets repositioned or a wall gets opened, because a reading that stalls means the wet side is not being reached.

  3. Day 3 to 4

    Convergence

    Most materials come down to standard here. Units that are no longer earning their place come out as they finish, which is also what keeps the mitigation invoice defensible.

  4. Day 4 to 5

    Final readings and out

    Last reading matches the dry standard, equipment leaves, and the drying log closes. That log is what goes to the adjuster and what proves the cavity was dry before anybody closed it.

Mitigation is billed the way carriers expect, which includes equipment per unit per day. That is precisely why units come out as they finish rather than all at the end: the log has to show the equipment was necessary for exactly as long as it was there.

Living with the drying

Usually yes, on a clean-water loss with the affected area contained. What you are signing up for is noise around the level of a running dishwasher in every affected room, air that feels warm and dry, and doors that have to stay in the position we set them. Where people typically leave is a Category 3 loss, a bedroom that is itself the affected room, or a household with somebody who has asthma or is immunocompromised.

This is the most common thing that goes wrong on an otherwise straightforward job. Drying is continuous, and eight hours off lets moisture migrate back out of the framing into the air and into materials that had already come down. It shows up in the next morning’s readings and it adds days at the far end. If a specific unit is intolerable, tell us and we will reposition or resize rather than have you switch it off.

It is noticeable and it is temporary. A full residential setup of air movers and a dehumidifier or two, running continuously for four days, is a meaningful but not alarming addition to one billing cycle. Worth knowing: this is a documented cost of the loss, so keep the bill and give it to your adjuster along with everything else.

Because the equipment is sized to the volume of affected air and the surface area of wet material, not to the room count. A bathroom whose water went under the wall into two adjacent closets and a hallway is four spaces to dry, and the dehumidifier has to be matched to all of it or the air movers are just circulating humid air.

It is the moisture content of comparable unaffected material in the same building, measured with a meter. Your kitchen framing tells us what your hallway framing should read. It is a number, and the equipment leaves when the number is met, not when a scheduled day arrives. You get the readings, so you can check the claim rather than take our word for it.

Often, if we reach it early. Injection drying pushes air directly beneath the boards through mats, which can bring a floor back before it cups permanently. Once boards have crowned, or the subfloor has delaminated, replacement becomes the honest answer and we will say so rather than run equipment on a floor that is already lost.
